← Home · Laboratory

Proctor Compaction Testing in Newcastle NSW: Standard & Modified Density Control

Together, we solve the challenges of tomorrow.

EXPLORE →

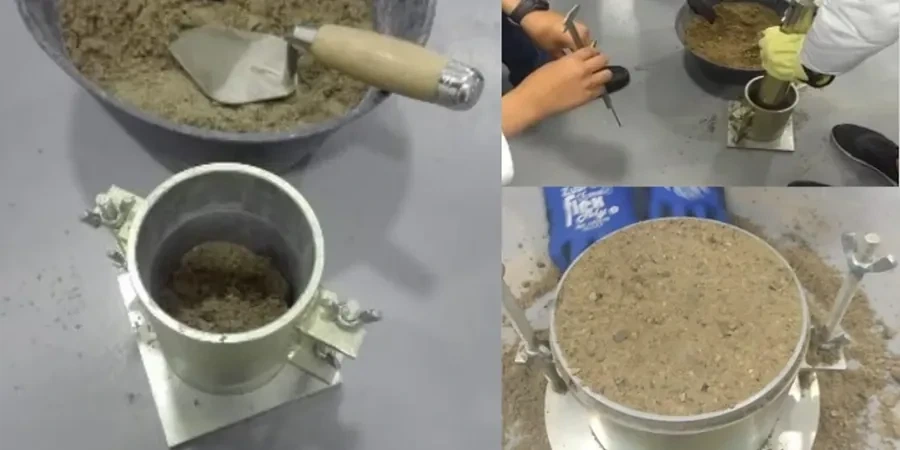

The subtropical humidity rolling in off the Tasman Sea creates a narrow window for achieving compliant compaction on Newcastle’s coastal plains and ridgelines. From the expansive claystone-derived soils of Fletcher to the sandy loams overlying the Newcastle Coal Measures in Wallsend, moisture conditioning is everything. A soil lifted at 2% above optimum can pump under a padfoot roller, while the same material compacted half a percent dry will leave a flocculated structure that settles the moment heavy rain infiltrates. Our NATA-accredited laboratory on the western fringe of the city runs both Standard and Modified Proctor tests (AS 1289.5.1.1 and AS 1289.5.2.1) to pin down the compaction curve that governs earthworks sign-off. For subdivision superintendents wrestling with reactive clay batters near the Sugarloaf Range, we often pair the Proctor with atterberg limits to predict shrink-swell behaviour before the first layer of structural fill is placed. The test itself is straightforward in principle—compacting five moisture-incremented specimens in a standard mould with a 2.5 kg or 4.9 kg rammer—but interpreting the zero-air-voids curve against a material’s specific gravity is where site-specific experience on the Permian geology of the Sydney Basin makes the difference between a passing lot and a costly rework.

A half-percent moisture deviation at the compaction layer can trigger a differential settlement claim six months after handover.

Scope of work

The compaction mould assembly we mobilise for Hunter Valley field verification is machined to AS 1289.2.1.1 tolerances: a 105 mm internal-diameter body with a detachable collar and baseplate, paired with a 50.8 mm-diameter rammer face that delivers a free-fall drop of 300 mm for Standard effort or 450 mm for Modified. The Standard Proctor applies a compactive effort of approximately 600 kN-m/m³ across three layers at 25 blows per layer, simulating the energy input of a 6-tonne smooth-drum roller making four to six passes on a 200 mm lift. The Modified Proctor ramps that up to roughly 2700 kN-m/m³—five layers at 25 blows—replicating the heavier dynamic compaction typical of mine haul roads and heavy-duty pavement subgrades around the Kooragang Island logistics precinct. When running the test on a clayey sand from a Stockton beachside development, the technician dry-sieves the material through a 19.0 mm or 37.5 mm sieve depending on oversize content, then progressively adds potable water in 1–2% increments, sealing each batch overnight to allow moisture equilibration. The entire curve, from the dry-of-optimum leg where matric suction holds the structure open to the wet-of-optimum leg where pore pressures begin to develop, is plotted with at least four points bracketing the peak so the field density technician can benchmark nuclear gauge readings against a laboratory-derived target.
Proctor Compaction Testing in Newcastle NSW: Standard & Modified Density Control
Technical reference image — Newcastle NSW

Area-specific notes

Newcastle’s geological patchwork—residual clay derived from the Newcastle Coal Measures interbedded with tuffaceous sandstone and chert—means the moisture-density relationship can shift dramatically across a single cut-to-fill transition. The biggest contractual risk on a bulk-earthworks package is accepting a Proctor reference that doesn’t represent the material actually being placed. A Modified Proctor run on a dry-screened sample from the crest of a Merewether cutting will overpredict the achievable density of the wet, plastic fines that the scraper picks up from the floor of the same excavation after a summer storm. The resulting field density tests then fail against an unattainable target, triggering unnecessary re-rolling, stabilisation with lime, or—in the worst case—strip-and-replace instructions that blow the programme by three weeks. Our approach on projects exceeding 10 000 m³ of fill is to run a rolling programme of Proctor curves keyed to material-source zones, updating the reference value whenever the material type or its natural moisture content shifts visibly. For sites underlain by the Lambton Formation—notorious for its smectite-rich seams—we also recommend determining the linear shrinkage alongside the Proctor so the superintendent can anticipate the moisture sensitivity before the padfoot roller hits the fill.

Need a geotechnical assessment?

Reply within 24h.

Email: contact@geotechnicalengineering1.co

Watch how it works

Technical parameters

ParameterTypical value
Test standard (Standard effort)AS 1289.5.1.1 – 3 layers, 25 blows/layer, 2.5 kg rammer
Test standard (Modified effort)AS 1289.5.2.1 – 5 layers, 25 blows/layer, 4.9 kg rammer
Mould dimensions105 mm internal diameter × 115.5 mm height
Oversize correctionAS 1289.5.4.1 (rock correction applied when >5% retained on 19.0 mm sieve)
Typical MDD range (Newcastle clay fill)1.72–1.94 t/m³
Typical OMC range (Newcastle clay fill)11.5–17.8%
Minimum points on compaction curve4 (two dry of optimum, two wet of optimum)

Linked services

01

Standard Proctor Compaction Test

Three-layer, 25-blow method simulating the compactive effort of conventional padfoot and smooth-drum rollers on residential and light commercial fills. Delivers the reference maximum dry density (MDD) and optimum moisture content (OMC) used for Level 1 inspection and testing plans under AS 3798.

02

Modified Proctor Compaction Test

Five-layer, 25-blow method replicating the higher energy input of heavy vibratory and impact compaction plant. Specified for mine infrastructure, TfNSW road embankments, and industrial slabs where post-construction settlement tolerances are tight.

03

Field Density Nuclear Gauge Correlation

On-site calibration of nuclear moisture-density gauges against the laboratory Proctor curve, including sand-cone verification at the same test location. Essential for converting raw wet-density readings into a relative compaction percentage the superintendent can act on immediately.

Standards used

AS 1289.5.1.1 – Soil compaction and density tests: Determination of the dry density/moisture content relation of a soil using standard compactive effort, AS 1289.5.2.1 – Soil compaction and density tests: Determination of the dry density/moisture content relation of a soil using modified compactive effort, AS 1289.5.4.1 – Compaction control test: Dry density ratio and moisture ratio using standard and modified effort, AS 3798 – Guidelines on earthworks for commercial and residential developments, RMS QA Specification R44 – Earthworks (adopted by Transport for NSW for road embankment control)

FAQ

What’s the difference between Standard and Modified Proctor, and which one does my Newcastle project need?

The Standard Proctor applies roughly 600 kN-m/m³ of energy using a 2.5 kg rammer dropped 300 mm over three layers, which approximates the compaction delivered by a 6-tonne smooth-drum roller on a 200 mm loose lift. The Modified Proctor ramps that to about 2700 kN-m/m³ with a 4.9 kg rammer dropped 450 mm over five layers, simulating heavy vibratory plant or impact rollers. Residential subdivisions across Lake Macquarie and Newcastle typically reference Standard effort. Heavy-duty pavements, mine haul roads, and rail formations—common in the Hunter Economic Zone and Kooragang Island—almost always specify Modified effort. If the project’s geotechnical specification simply says “AS 3798” without nominating an effort, we ask the superintendent to confirm whether the compaction plant on site matches Standard or Modified energy before we run the curve.

How long does a Proctor test take, and how much material do you need?

A single-point Proctor determination—one moisture content compacted into the mould—can be turned around in under four hours. A full five-point compaction curve with overnight moisture equilibration typically takes one full business day from sample receipt to issued report. We need about 25 kg of representative material for a Standard Proctor and 35 kg for a Modified Proctor when oversize correction is required. The sample should be delivered in sealed plastic bags or buckets so the natural moisture content is preserved; if the material arrives oven-dry from sitting in the back of a ute all day, the curve will be shifted and the OMC will read artificially low.

What does Proctor compaction testing cost in Newcastle?

A Standard Proctor (full curve, four to five points) generally falls between AU$160 and AU$240 depending on whether oversize correction is needed. A Modified Proctor runs from AU$220 to AU$320 for the same scope. Volume discounts apply when we run a rolling programme of curves across multiple material zones on larger subdivisions; talk to the lab manager about a bulk rate if you expect more than six curves across the project.

Why did my field density test fail when the Proctor curve said the material should compact easily?

The most common culprit on Hunter sites is a mismatch between the Proctor reference material and the fill actually being placed. If the lab ran the curve on a dry-screened sample from the top of the cut but the scraper is now working wet clay from a metre lower, the reference MDD is no longer valid. Other causes include breakdown of friable sandstone particles under the roller—changing the grading and therefore the compaction curve—or using a nuclear gauge that hasn’t been correlated against a sand-cone at that specific density range. The fix is to run a new Proctor on the material as it is being placed, not as it looked during the investigation phase, and to calibrate the gauge against a direct volume measurement at least once per material type.

Location and service area

We serve projects across Newcastle NSW and its metropolitan area.

View larger map
>
